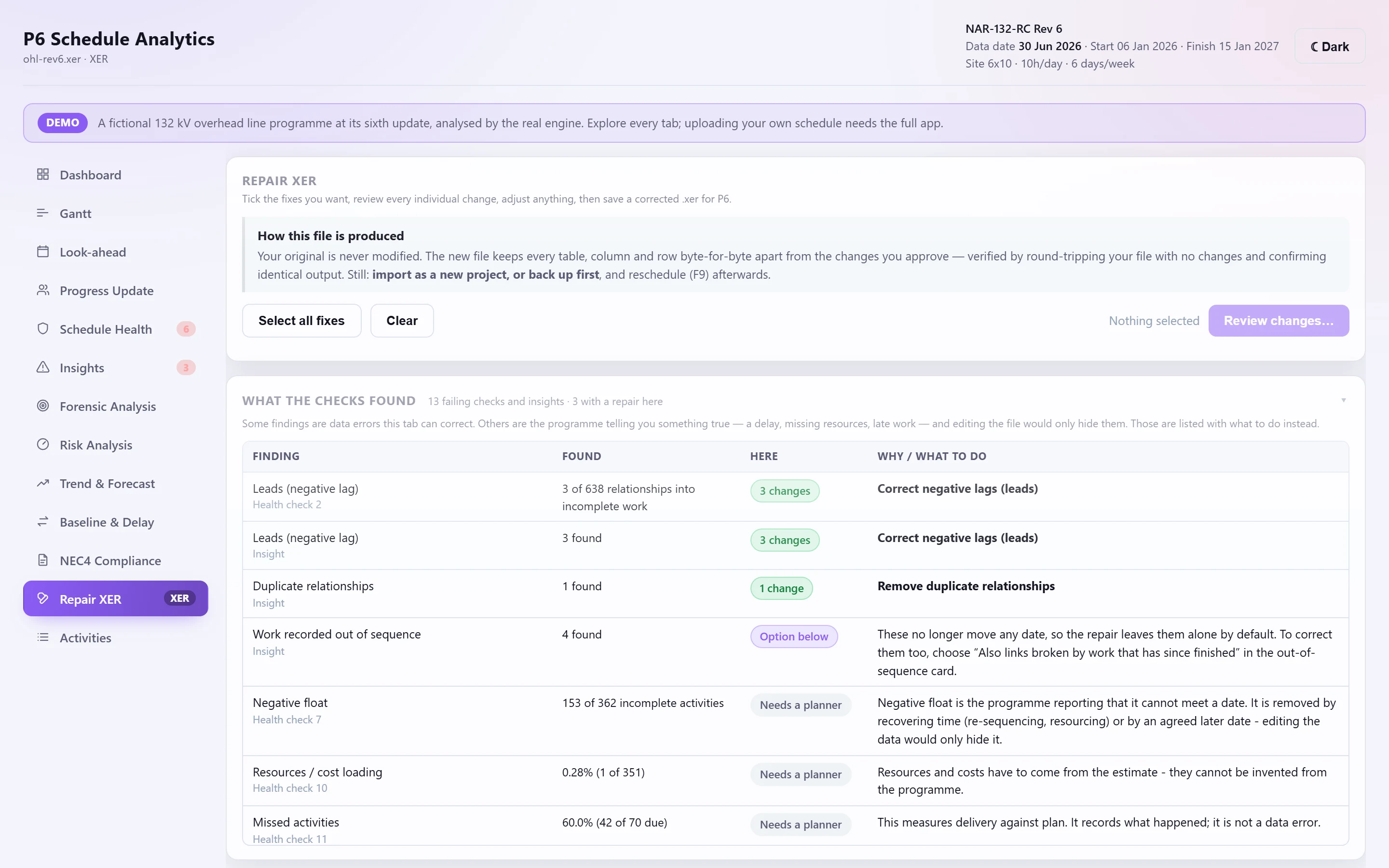

Choose the fixes, review every proposed change, edit any of them, and download a corrected XER. The original file is edited cell by cell, never regenerated, so an unchanged round trip is byte-identical.

Repair XER: proposed fixes listed for review before a corrected file is written.
Repair XER · demo programme Rev 6

What it gives you

The fixes

  • Duplicate relationships and self-referencing logic.
  • Out-of-sequence logic, relaxed to the SS or FF the actual dates still satisfy.
  • Dangling ends, given their partner link where the dates allow it.
  • Redundant relationships, removed only when provably implied.
  • Negative lags, remaining duration on completed work, hard constraints and milestone durations.

And what it won't touch

Negative float, missing resources and missed work are the programme reporting something true. The tab lists them with the reason a planner has to act, rather than editing the file to hide them.
